Pueblo Safe Streets for All Project: Public Engagement Plan
Overview
The City of Pueblo seeks to develop a Comprehensive Safety Action Plan (CSAP) that will identify roadway safety infrastructure projects and programs to enable the City to compete for surface road, bridge, and other infrastructure grants. The plan will utilize funding from the Safe Streets for All (SS4A) program to significantly reduce or eliminate roadway fatalities and serious injuries. The following engagement plan will outline the engagement strategy as well as key meetings and activities.
Engagement Strategy Map
Effective engagement requires a clear understanding of the project vision, mission, and values which are described in Table 1 below, the macro view of the Comprehensive Safety Action Plan strategy. Additionally, to ensure that the CSAP engages effectively with the City of Pueblo community, understanding the Outreach Goals, Key Performance Indicators, and Key Outreach Activities is essential; these are detailed in Table 2, the micro view of outreach strategy.
Table 1 Engagement Strategy Map Macro View
| Vision What does this project seek to achieve? | Mission (Project Goal/Deliverable) How will the project work towards its vision? | Values & Guiding Principles What principles guide project actions, decisions, and outreach efforts? |
|---|---|---|
| To create a safer, more equitable transportation system for the City of Pueblo by significantly reducing roadway fatalities and serious injuries, ensuring accessibility and security for all modes of travel, and fostering a culture of safety that prioritizes the well-being of all community members | To develop an evidence-based Comprehensive Safety Action Plan that identifies actionable strategies, innovative safety measures, and prioritized infrastructure projects to maximize crash reduction, enabling the City of Pueblo to secure funding and implement solutions to improve transportation safety for all users |
|
Table 2 Engagement Strategy Map Micro View
| Outreach Goals | Goal 1: Inclusive Outreach | Goal 2: Clear, Collaborative Communication | Goal 3: Authentic Participation |
|---|---|---|---|
| What factors must we excel at to be effective in achieving our vision and mission? | Ensuring meaningful engagement with diverse community groups, particularly underserved populations such as BIPOC, New Americans, and economically disadvantaged communities Tailoring outreach methods to meet cultural, linguistic, and accessibility needs of all stakeholders | Providing transparent, easy-to-understand information about the project’s goals, safety challenges, and proposed solutions Using consistent and tailored messaging across all platforms Utilizing visual tools like maps and infographics to enhance understanding and foster trust Establishing strong relationships with local organizations, community leaders, and stakeholders to act as bridges for reaching and mobilizing diverse groups effectively | Empowering community members to actively contribute by incorporating their feedback into the decision-making process Demonstrating responsiveness by integrating community feedback into actionable recommendations and clearly communicating how public input shapes the project’s direction and outcomes |
| Key Performance Indicators (KPIs) How will we measure our success? |
|
|
|
| Key Outreach Activities (Deliverables) What specific activities must we do in order to meet our KPIs and be successful? |
|
|
|
Target Audiences
- Local community members
- Residents
- Older adults
- Economically disadvantaged communities
- BIPOC, New Americans, and historically marginalized communities
- Communities disproportionately impacted by traffic risks and underserved by safety efforts
- Youth/schools
- People with disabilities
- Local biking community
- Activist groups
- Visitors, commuters, and transit users
- Local decision makers and businesses
- Elected officials
- Large employers
- Local businesses
Engagement Meetings (3)
The Consultant Team will meet with three main groups of stakeholders at key milestones throughout the project, based on project needs determined in conjunction with the City of Pueblo. These meetings will be composed of representative agencies and organizations that can provide input and help guide the development of the Comprehensive Safety Action Plan. The table below provides a breakdown of stakeholder groups, members, and proposed meeting times.
Meeting 1: Internal Working Group
- CDOT staff
- County staff
- PACOG MPO Transportation Advisory Committee
Meeting 2: Elected Leaders and Key External Stakeholders
- PACOG Executive Board
- Law Enforcement
- School Districts
- Community Groups
- Chambers of Commerce
Meeting 3: Public Presentation
A meeting will be planned in June to present a set of safety improvement projects to the public and solicit feedback. If in-person, a meeting location will be selected to ensure accessibility and inclusivity. The meeting may be organized to allow for focus groups or small group roundtables to take a deeper dive into special interests, particular corridors, or city quadrants.
Targeted Discussions (as needed)
Targeted discussion meetings will be scheduled as needed to provide space for the City and Consultant team to connect with specific stakeholders. These meetings may address concerns along key corridors where projects may impact surrounding businesses or other identified stakeholder groups. The Consultant Team will prepare a list of potential corridors for discussion and collaborate with the City to schedule meetings and invite attendees.
Online Community Survey (1)
The Consultant Team will develop one online community survey using ArcGIS StoryMaps that will solicit qualitative and quantitative public input related to key decisions, stakeholder sentiment, and/or project preferences.
Public Engagement Summary
The Consultant Team will track outreach and engagement activities throughout the project. A final engagement summary will be presented to synthesize outcomes and themes from online engagement, engagement meetings, the public presentation, endorsement meetings, and the online community survey.
General Outreach Schedule

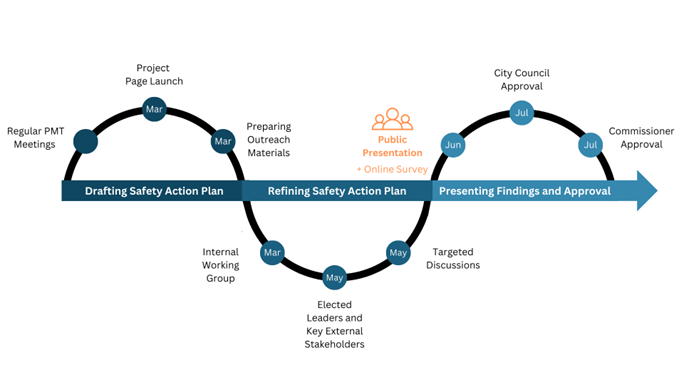

The graphic below provides a general schedule for outreach, starting with the launch of the project page in February 2025, the first public-facing communication tool. Three engagement touchpoints will occur via meetings with the Internal Working Group, Elected Leaders and Key External Stakeholders, and Public Presentation which will create space for the community to participate in the planning process.
Outreach Activities
Promotion Methods
In an effort to equitably reach all target audiences, outreach will emphasize a multi-faceted promotion strategy with visually-pleasing, accessible materials available in English and Spanish. This ensures that all audiences are reached according to their preferred communication channel. The Consultant Team will collaborate with local partners and stakeholders to promote engagement opportunities, increasing visibility and public participation. Options for promoting engagement opportunities include:
- E-Blasts: Using email software like MailChimp or similar, the Consultant Team can keep stakeholders informed with regular project updates and opportunities to provide input.
- Social Media: When communicating to the broader public, the Consultant Team will work with the Pueblo communications team to use City of Pueblo social media channels to promote project-related materials – including surveys, the project website, or meeting information.
- City of Pueblo Facebook, Twitter (X), or Instagram
- Social media links shared with Community Partners to repost
- Postcards or Flyers: Since digital access can be a barrier to engagement for some, the Consultant Team has the ability to develop “low-tech” or analog communication materials, such as postcards or flyers for use by the City of Pueblo Communication Team, to inform community members and stakeholders of project updates and opportunities
- Existing Community Newsletters and Listservs: Using newsletter platforms of the City of Pueblo and local community organizations to advertise key engagement opportunities is an effective strategy to reach a broad audience (e.g., City Newsletter)
- Yard Signs: If desired, yard signs may be used to promote community meetings.
- Local Press: The Pueblo Chieftain and the Pueblo Star Journal may be an effective route to advertise the public presentation and the final project results
- Utility bill inserts or regular mailers generated by the City of Pueblo
- “Share Kits”: City of Pueblo Public Information Officers (PIOs) can distribute outreach materials as they see fit
- Community Partners: the below community partners as well as others recommended by the city and project management team could assist with outreach and promotion of engagement opportunities throughout the project if the project aligns with their mission and outreach goals:
- Pueblo County Government
- Visit Pueblo
- Large Employers
- HOAs
- School Groups
- Other Community Organizations
- Pueblo Bike Riders
- Cruisin’ Pueblo
- Pueblo Composite Mountain Bike Team

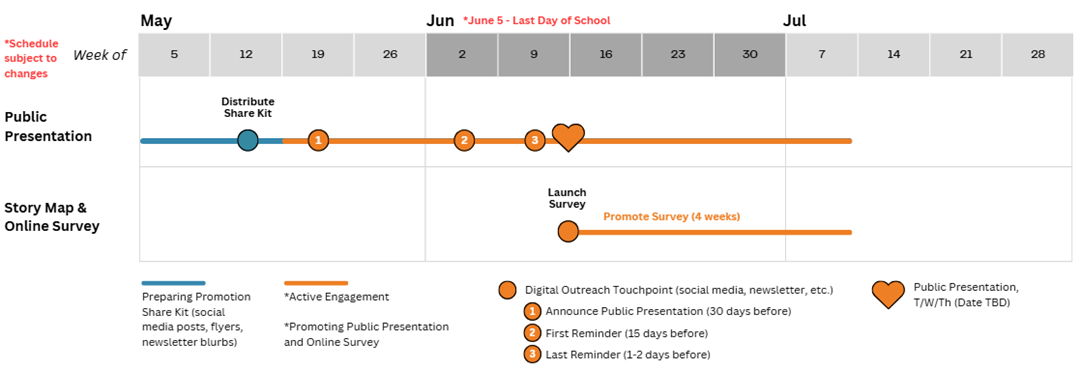

Promotion Schedule
Activity Details (February – July, 2025)
| Project Phase | Outreach Task | Timeframe | Details |
|---|---|---|---|
| Drafting Plan and Engagement Preparation | Finalize Public Engagement Plan | February 2024 | The Consultant Team will create a Public Engagement Plan that utilizes multiple outreach methods to best reach target audiences:
|
| PMT Meetings | Throughout the project | The PMT will meet regularly throughout the project to provide updates and coordinate next steps. | |
| Contact List | March 2025 | The Consultant Team will prepare a contact list to track key organizations and individuals to collaborate with for outreach. Outreach “share kits” may be distributed through this partner network. | |
| Project Page + Updates | March 2025 | The Consultant Team will support Pueblo and collaborate with Pradeep Diska as needed in creating a project page to be hosted on Pueblo, CO - Official Website | Official Website. This allows the public to view the project background, participate in the online survey, and view project updates. | |
| Outreach Materials | March 2025 | The Consultant Team will develop outreach materials to support promotion of the project and engagement opportunities. These may include a project one-pager, press releases, newsletter wording, a flyer for the public presentation, and social media post templates. All outreach materials and communications will be developed according to Pueblo’s communication and marketing guidelines, including the accessibility standards. | |
| Refining Safety Action Plan | Internal Working Group | Tuesday, March 11 1:30 – 3:30 PM | The Consultant Team will meet with City, CDOT, and County staff as well as the PACOG MPO Transportation Advisory Committee (TAC) made to provide input and help guide the development of the Safety Action Plan. Meeting materials (e.g., slide deck and proposed agenda) will be created and shared by March 4, the week before the meeting. The presentation will be allotted 30 minutes with additional time for conversation and questions as necessary. The Consultant Team will coordinate invitations with Eva Cosyleon and Haley Robinson. |
| Elected Leaders and Key External Stakeholders | Thursday, May 22 (TBD) 12:00 PM – 1:30 PM (TBD) | Following review of the CSAP draft by the Internal Working Group, a meeting will be planned to present to key external stakeholders and elected leaders:
The Consultant Team will coordinate invitations with Eva Cosyleon and Haley Robinson. | |
| Targeted Discussions | May - June (preceding public presentation) | Targeted discussion meetings will be scheduled as needed to provide space for the City and Consultant team to connect with specific stakeholders. These meetings may address concerns along key corridors where projects may impact surrounding businesses or other identified stakeholder groups. The Consultant Team will prepare a list of potential corridors of discussion and collaborate with the City to schedule meetings and invite attendees. | |
| Public Presentation | June 2025 (avoiding week of June 2, last week of school) | The Consultant Team will design and facilitate a presentation to provide the public with a set of data-driven project recommendations. Public feedback will help select and prioritize desired projects to include in the final CSAP. The meeting may be organized to allow for focus groups to take a deeper dive into special interests, particular corridors, or quadrants of the city. Based on the needs of the city and county, the meeting will be in-person with potential locations below:
Potential dates include a Tuesday, Wednesday, or Thursday in June with consideration for the last week of school being the week of June 2. Public presentation invites will be shared via social media, newsletters, flyers, and other desired channels. | |
| Online Community Survey and Story Map | June 2025 | The Consultant Team will develop a survey using ArcGIS StoryMaps and GeoForm that will provide project background and allow for qualitative and quantitative input related to key decisions, stakeholder sentiment, and/or project preferences. The online public-facing survey will launch on the day of the public meeting and remain open and be promoted for at least 4 weeks. | |
| Public Engagement Summary | July 2025 | The Consultant Team will track all outreach and engagement activities throughout the project. A final engagement summary will be presented to synthesize outcomes and themes from online engagement, engagement meetings, endorsement meetings, and the online survey. | |
| Pre-final Presentation to City Council | July (Date TBD) Monday evenings | Presentation of the CSAP to Pueblo City Council | |
| Pre-final Presentation to County Commissioners | July (Date TBD) | Presentation of the CSAP to Pueblo County Commissioners |
